In this chapter, you will learn how to do the following:
A change order class determines which project data—the revenue budget, the cost budget, commitments, or any combination of these—can be adjusted with a change order of this class.
Two-tier change management is controlled at the level of a change order class. If the Two-Tier Change Management check box is selected for a class on the Change Order Classes (PM203000) form, change orders of the selected class can include change requests.
The selected check boxes on the form determine how change orders of the class are processed:
For revenue change orders, you can release the cost budget and create commitments before releasing revenue budget changes. For details, see Single-Tier Change Management: Releasing Costs Only.
If the project cost budget and commitments affected by a change request need to be updated through a separate change order before the revenue part has been approved, for this change request, you process a cost change order and a revenue change order.
A cost change order is a change order that contains only the cost and commitment parts of the change request based on the settings of the selected change order class. This change order created for a change request is shown in the Cost Change Order Nbr. box in the Summary area of the Change Requests form.
A revenue change order is a change order that contains the revenue part of the change request as well as all types of estimation lines—that is, revenue budget lines, cost budget lines, and commitment lines. This change order created for a change request is shown in the Change Order Nbr. box in the Summary area of the Change Requests form.
To make it possible for users to track changes for a particular project by using change requests along with change orders, you select the Change Order Workflow check box on the Summary tab of the Projects (PM301000) form for the project. Then you can create a change request for the project on the Projects form by clicking Create Change Request on the form toolbar. The system creates a change request with the On Hold status and the project selected and opens it on the Change Requests (PM308500) form.
In addition to creating a change request from the Projects form for the selected project, you can create a new change request directly on the Change Requests form and select the needed project.
In a change request with the On Hold status, on the Estimation tab of the Change Requests form, you add rows with potential changes that will affect the revenue budget and the cost budget of the selected project when the related change orders are released. For each estimation line, you specify the following settings:
The amount in the Ext. Cost column estimates the change of the cost and is calculated as follows:
Ext. Cost = Quantity * Unit Cost
The amount in the Line Amount column estimates the change of the revenue and is calculated as follows:
Line Amount = Ext. Price + Ext. Price * Line Markup (%) / 100, where
Line Amount = Ext. Price + Ext. Price * Line Markup (%) / 100
Ext. Price = Quantity * Unit Price
Unit Price = Unit Cost + Unit Cost * Price Markup (%) / 100
Once you have saved a change request with the Open status, the Quantity and Ext. Cost values of each estimation line increase the Potential CO Quantity and Potential CO Amount of the corresponding cost budget line of the project on the Projects form. The Quantity and Line Amount values of each estimation line increase the Potential CO Quantity and Potential CO Amount of the corresponding revenue budget line of the project.
On the Change Requests (PM308500) form, you can create a change order for the selected change request by clicking the Create Change Order button on the form toolbar. On the Change Orders (PM308000) form, you can also add one or several change requests to the selected change order by clicking Add Change Requests on the table toolbar of the Change Requests tab.
Based on each estimation line of the change request added to a change order and on the selected change order class, the system creates the following lines for the change order on the Change Orders form:
Most commonly, a change request relates to a change order that contains both cost estimation lines and revenue estimation lines. Once you have added the change request to the change order, the change request is assigned the Closed status. However, in some cases, you may need to process and release the cost change order as early as necessary to create commitments and change the project cost budget accordingly, while the revenue change order may require customer approval and needs to be processed separately.
When both the cost part and the revenue part of a change request have been linked to change orders, the system assigns the Closed status to the change request. If the customer has not approved the revenue part of the change request, you do not need to create a revenue change order and can manually close the change request for which the cost change order has been created. To do this, you click Close on the form toolbar of the Change Requests form to assign the change request the Closed status.
You can also cancel a change request by clicking Cancel on the form toolbar of the Change Requests form to indicate that the changes will not be processed further. This will assign the change request the Canceled status and decrease the potential CO values in the project budget.
For information on further processing of change orders, see Single-Tier Change Management: General Information.

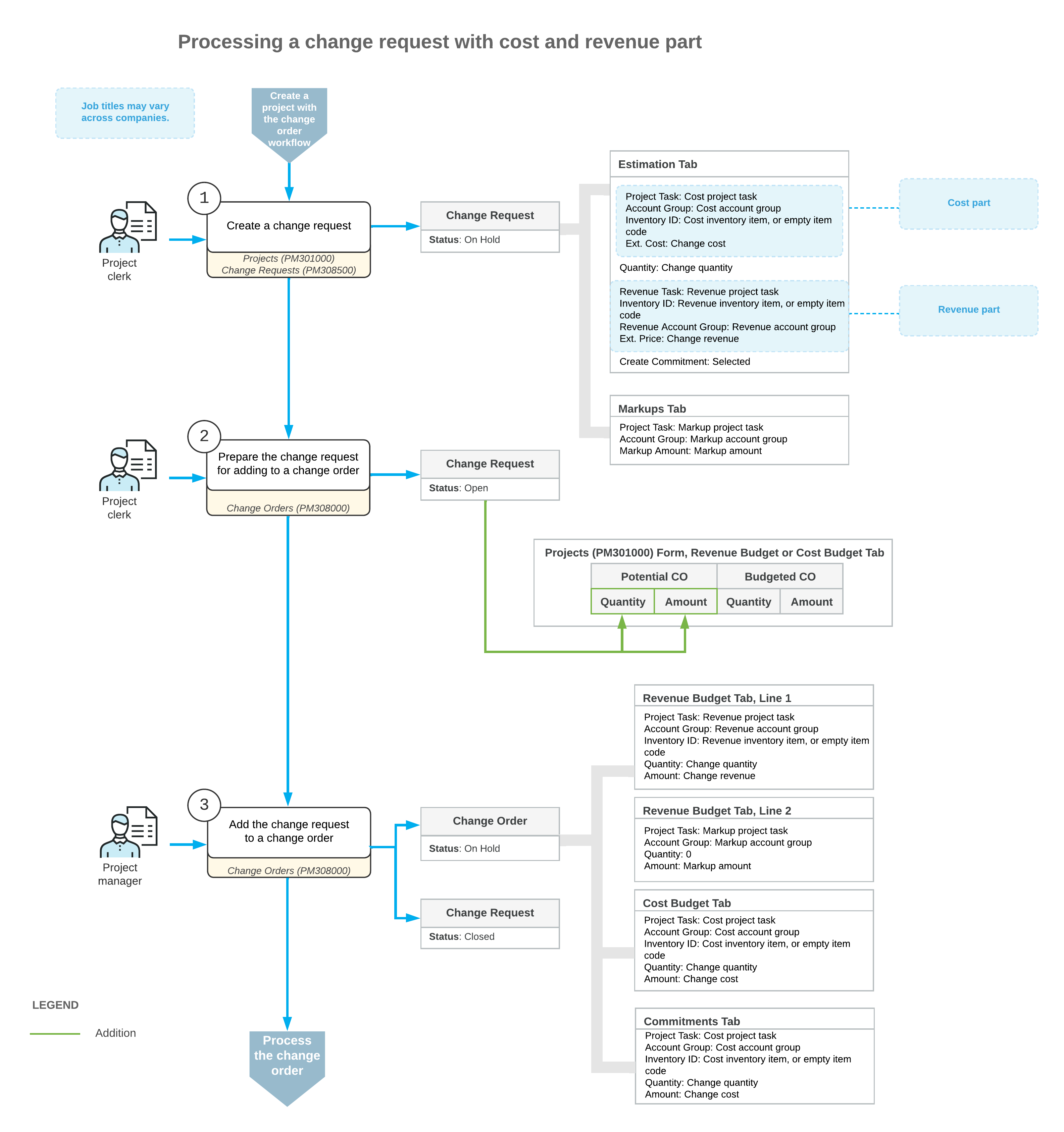

The following diagram illustrates the workflow of processing a change request.
